Published pricing

Metal building pricing

Most contractors will not put this on a website. Here it is. Price per square foot drops as the building grows, because the fixed costs spread further. If these ranges do not work for your budget, you have saved a phone call.

Commercial shell

Includes engineered frame, roof and wall panels, slab and foundation, doors, erection, permits and basic site grading. Dried in and usable.
Building sizePer SF
1,500 - 2,999 SF$52 - $68
3,000 - 4,999 SF$46 - $58
5,000 - 9,999 SF$38 - $50
10,000 - 19,999 SF$32 - $42
20,000 SF and up$27 - $36

Commercial turnkey

Shell plus insulation, HVAC, electrical, plumbing, interior framing and finishes. Move-in ready. Use type moves the number more than size does.
Building sizeWarehouse, light industrialRetail, office, flex
1,500 - 2,999 SF$98 - $125$125 - $165
3,000 - 4,999 SF$88 - $112$112 - $148
5,000 - 9,999 SF$78 - $100$100 - $132
10,000 - 19,999 SF$68 - $88$88 - $118
20,000 SF and up$60 - $78$78 - $102

Barndominiums

Living area only. Finish level drives the number, not size.
Finish levelWhat it isPer SF
Shell, dried inSlab, frame, roof, wall panels, windows, exterior doors. No interior.$62 - $78
Basic finishSpray foam, HVAC, standard cabinets, LVP flooring, builder-grade fixtures.$118 - $138
Mid finishQuality cabinets, mixed flooring, upgraded fixtures and trim.$145 - $172
High finishCustom cabinets, stone counters, premium fixtures, custom features.$185 - $225

Under 2,500 SF, add 10 percent. Fixed costs do not shrink with the house. Attached shop or garage space runs $48 - $62 per SF.

Finish allowances

What your number actually buys at each finish level. Go past these and the price moves, which is the honest version.
ItemBasicMidHigh
Cabinets and countertops$18,000$34,000$62,000+
Flooring$5/SF$9/SF$16/SF
Plumbing fixtures$6,000$12,000$25,000+
Appliances$7,000$14,000$30,000+
Lighting and electrical trim$5,000$9,000$18,000+

Specialty structures

Public occupancy carries engineering, fire and accessibility cost a warehouse does not. These get priced individually.
StructurePer SF
Clear-span shell, 60 ft span and over$58 - $82
Churches and event venues, finished$135 - $195
Distilleries, finished production and tasting$165 - $240
Cabanas and covered pavilions, finished$115 - $210
Greenhouses$45 - $95
Agricultural, open or semi-enclosed$28 - $48

The small end

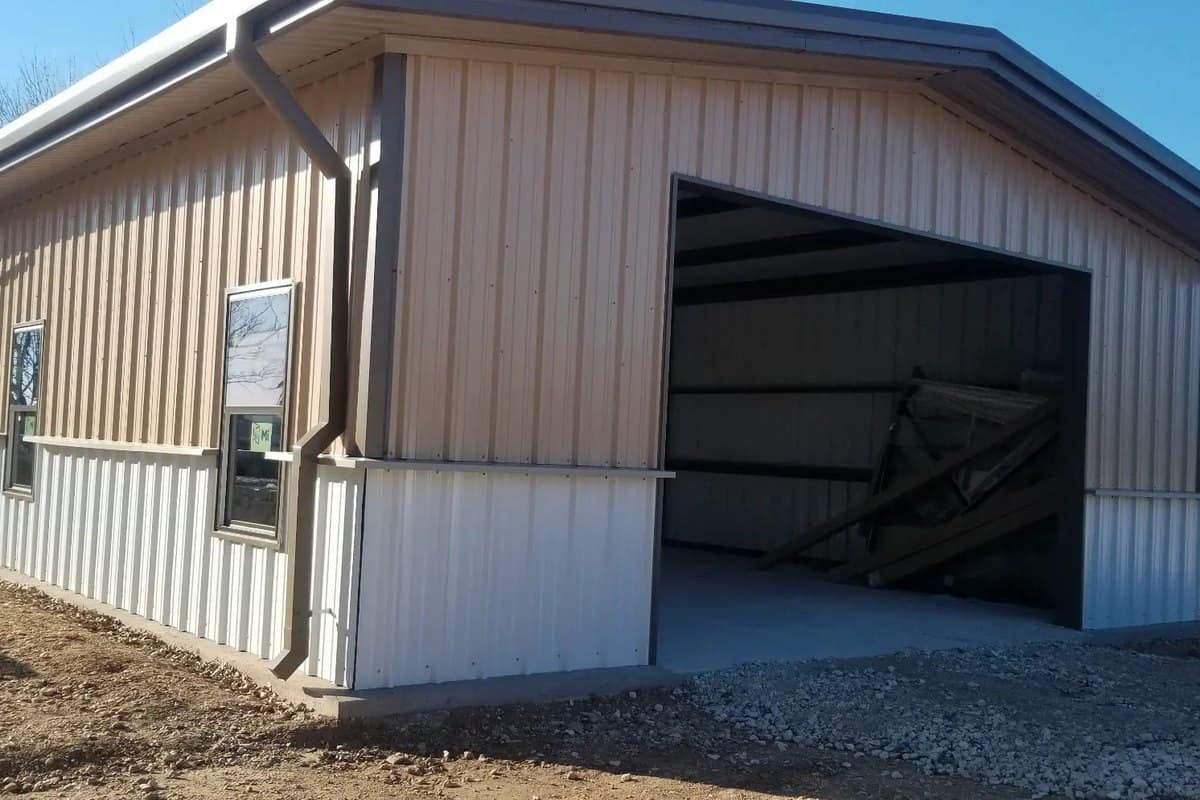

small commercial shop white metal single bay exterior
Single bay commercial shop. Around the smallest building we take.

Small buildings cost more per foot

Engineering, permits, mobilization and the crane cost about the same on a 2,000 SF building as on a 20,000 SF one. Those costs spread thinner as the building grows, which is why the top row of every table on this page is the most expensive one.

Worked examples

5,000 SF warehouse

Shell at $38 - $50 per SF

$190K - $250K

Turnkey at $78 - $100 per SF is $390K to $500K.

15,000 SF industrial

Shell at $32 - $42 per SF

$480K - $630K

Turnkey at $68 - $88 per SF is $1.02M to $1.32M.

2,500 SF barndominium

Mid finish at $145 - $172 per SF

$363K - $430K

Plus land, septic, well, driveway and utilities.

Not included in any number

Not included in any number we quote. On rural East Texas land these routinely add $30,000 to $100,000 or more before we pour anything.

  • Land
  • Well or water tap
  • Septic system or sewer tap
  • Utility extension to the site
  • Driveway and culvert
  • Land clearing beyond one acre
  • Rock excavation
  • Retaining walls
  • Detention and drainage improvements
  • Impact and development fees
  • Furniture, fixtures and equipment

How we contract

  • Quotes are good for 30 days. Steel moves.
  • Lump sum against a written scope. Not cost-plus.
  • Draws at deposit, slab, steel delivered, dried in, rough-in, and substantial completion.
  • Price escalation applies only above a stated steel index move, written into the contract.

Is this a fit

We're probably not your builder if

  • You need a repair or a service call.
  • You're looking at a shed, a carport, or a kit.
  • You want the steel dropped and nothing else.

We're a fit if

  • You're building 1,500 SF or more of finished commercial or industrial space.
  • You're building a 2,000 SF or larger home on your land.
  • You want one contractor from slab to final finish.

Questions

Why does the price per square foot go down as the building gets bigger?
Fixed costs. Engineering, permits, mobilization, the crane, the crew getting to site. Those cost roughly the same on a 2,000 SF building as on a 20,000 SF one, so they spread thinner across a bigger footprint. Any contractor quoting one flat rate for every size is either overcharging small jobs or losing money on big ones.
Are these real numbers or a teaser?
Real ranges we will stand behind at the budget stage. Where you land inside a range depends on eave height, span, doors, insulation, site conditions and county. A written quote comes after we walk the site.
Is the slab included?
Yes, in every number on this page. A lot of published metal building pricing excludes the foundation, which is why those numbers look lower. Foundation runs $8 to $12 per square foot on its own and it is not optional.
Do you do cost-plus?
No. Lump sum against a written scope. You get one number and a document that says what it covers.
How long is a quote good for?
Thirty days. Steel moves, and 2026 tariff policy could move it further. Past thirty days we requote rather than eat the difference or pass you a surprise.

Where these numbers come from

Guide

Metal building cost in Texas

What a metal building actually costs in Texas in 2026, by size and by scope, with the site costs nobody puts in the brochure number.

Guide

What a slab actually costs

Foundation cost per square foot in Texas by loading, why Blackland clay changes the design, and why leaving the slab out of a quote makes it look cheap.

Guide

Shell versus turnkey

What a dried-in shell includes, what turnkey adds, what the gap costs, and how to tell which one is right for your project before you sign anything.
